Key takeaways

  • A certificate of occupancy authorizes a stated use of a building or defined space. Check that the approval covers the area and activity in the business plan.
  • New construction and changes of use commonly require occupancy approval. Tenant changes, alterations, and existing-building exemptions depend on local rules.
  • A temporary certificate can permit occupancy before final closeout. Its scope, conditions, and expiration date need active tracking.
  • Match the rent forecast to the units or spaces approved for occupancy, then apply the lease’s actual rent commencement terms.

A certificate of occupancy affects when tenants can use a property and whether the planned use is authorized. For an owner, that makes it part of both acquisition diligence and the operating forecast.

The existing approval may work for the current tenant but require amendment for a new use. A development may also receive permission to occupy only part of the building. In either situation, the investment team needs to establish what the local authority has approved before relying on the projected income.

What is a certificate of occupancy?

A certificate of occupancy, usually called a CO, is a document issued by a local building authority that authorizes occupancy for a specified use. Issuance generally follows required inspections and approval of the relevant work and records.

The certificate’s scope matters. An approval for office use does not establish that a proposed restaurant can open in the same space. Commercial zoning determines permitted land uses; the occupancy review checks the building or space against applicable requirements for the approved use. Business licenses and other operating permits may also be required.

Keep a physical-condition review in the acquisition process. The CO establishes an approved occupancy status; it does not replace an assessment of the property’s current condition or future capital needs. An approval that limits usable area can also affect value assumptions in a commercial property appraisal.

When a certificate of occupancy is required

Common triggers include a newly constructed building, a conversion to a different use, or alterations that affect occupancy or exits. Local rules can also require a new certificate when a tenant changes, even if the intended use stays the same.

For example, Dallas lists a change of tenant among the events requiring a new CO, alongside first use, a change of use, and a change in floor area. This is a useful check for a leasing team taking over an existing retail or office suite.

For an acquisition, establish whether the existing approval remains valid and whether the sale itself triggers a local inspection or certificate requirement. Closing conditions also depend on the purchase agreement and financing documents. An “as-is” clause does not itself authorize occupancy.

The landlord and tenant should allocate responsibility for applications, base-building work, and tenant improvements in the lease. The relevant authority’s requirements still apply regardless of who pays for the work.

Final and temporary certificates and completion documents

A final CO and a temporary certificate of occupancy (TCO) allow occupancy within their stated scope. A completion document addresses the closeout of particular work. Check the local terminology and the authority granted by each document.

DocumentWhat it establishesWhat to verify
Final COApproval for the stated use and covered area after required closeoutWhether current conditions and the intended use match the approval
Temporary COPermission to occupy the specified area while outstanding items are resolvedCovered units or floors, conditions, expiration, and renewal requirements
Certificate or letter of completionCompletion or sign-off of the work covered by the permitWhether a separate occupancy approval is required

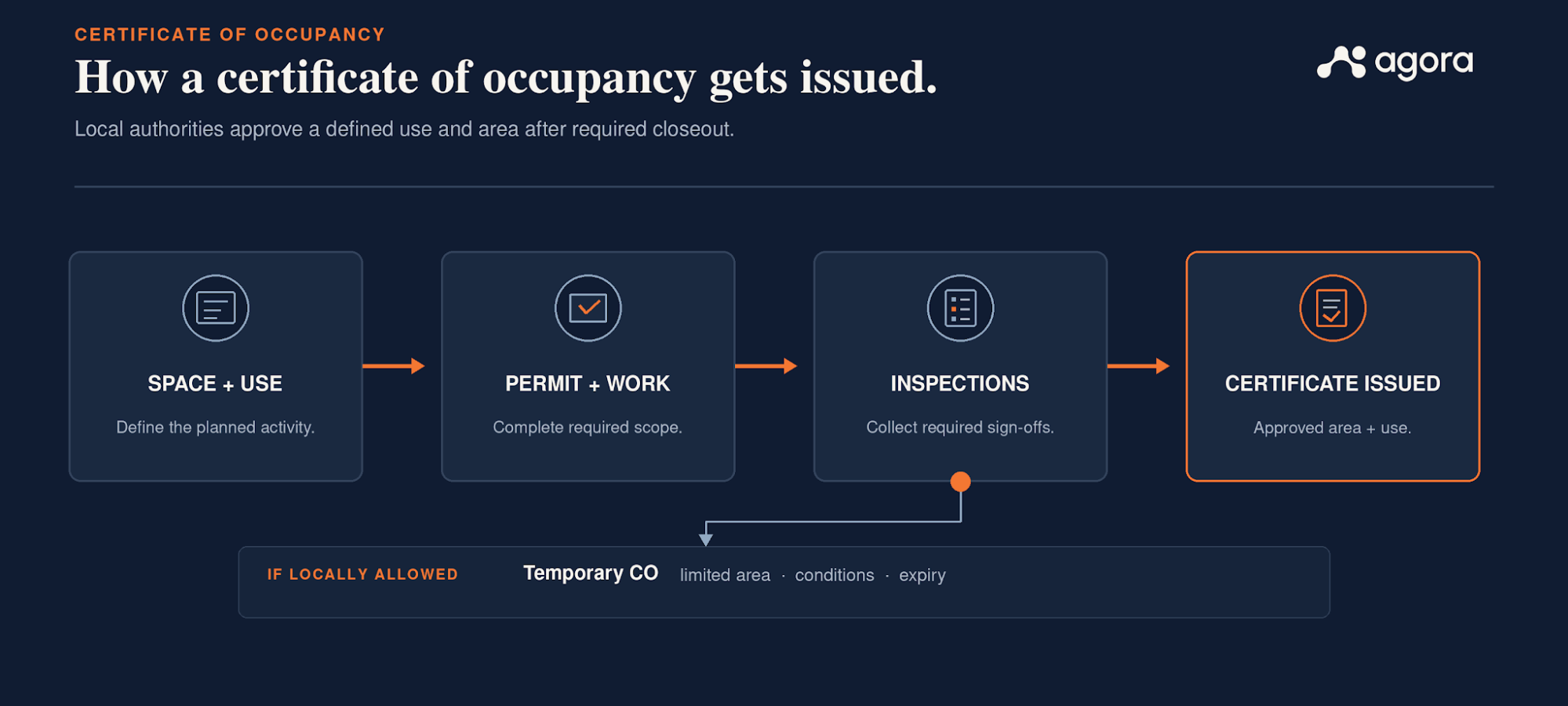

Occupancy approval applies to a defined use and area. The diagram outlines the approval process; the required steps and documents vary by jurisdiction.

Certificate of occupancy process: define space and use, complete permits and work, pass inspections, then receive the certificate.

A TCO can support a phased opening when the authority determines that the relevant space is safe to occupy. Its validity period varies by jurisdiction. New York City’s TCO guidance says these certificates typically expire after 90 days and may be renewed if final-CO issues remain unresolved. That period is a local example, not a national deadline.

Before a temporary approval expires, confirm the outstanding work, required submissions, and who owns the renewal process. Also confirm that the lender accepts the proposed certificate for the relevant funding milestone and that insurance coverage fits the stage of occupancy.

How to verify an existing certificate of occupancy

Start with the building department’s official records, using the property address and any available parcel or building identifier. Obtain the latest issued certificate and amendments. Review the permit history for later work that could affect the approved use or layout.

New York City’s CO guidance explains how to find records through BIS and DOB NOW. It also identifies an important exception: buildings predating 1938 may be exempt unless later alterations changed their use, egress, or occupancy. A Letter of No Objection may establish legal use for an eligible building. An absent certificate therefore needs investigation against the local rules.

Read the approval against the actual property and proposed leases. Check:

  • Identity and coverage: Address, building, suite, floor, or units included. Reconcile differences in numbering with the approved plans.
  • Approved use and limits: The permitted activity, occupancy classification, and any stated capacity or unit count.
  • Status and conditions: Final or temporary approval, issue date, expiration where applicable, and restrictions on use.
  • Later work: Alterations, open permits, or violations that require clarification from the authority or the project’s design professional.

Certificates vary in format. Some details appear in a schedule, approved plan, or associated record. Request those records when the certificate alone does not establish the scope.

As part of commercial real estate due diligence, resolve a material mismatch before treating the affected space as available under the business plan. Record the required correction, responsible party, and effect on closing or occupancy timing.

How to obtain a certificate of occupancy

The sequence depends on the jurisdiction and project. Establish the closeout requirements while planning the work so inspections and supporting documents are ready when needed.

  1. Confirm the approval path. Ask the building authority what the proposed use requires, whether an existing approval can remain in place, and whether phased occupancy is available.
  2. Identify the application requirements. Assemble the required plans, use information, and permit records. Confirm who can submit and which separate agency approvals are needed.
  3. Complete the required work. Obtain the required construction permits before work begins, and keep approved plans aligned with the work. Resolve design changes through the required review process.
  4. Obtain inspection sign-offs. Coordinate building and applicable trade or fire inspections. Make the site and records available, then address failed items and arrange reinspections.
  5. Close out the file. Submit the required certifications, resolve outstanding approval conditions, and pay applicable fees. Confirm that the authority has received each item.
  6. Verify the issued certificate. Check its area, use, conditions, and dates before the affected space is occupied. Give the operating team the final record and any remaining obligations.

If approval is held up, request the specific outstanding items and the evidence needed to clear them. A failed inspection, a missing professional certification, a pending agency review, or a records gap each requires a different next step. Track each item to an owner and a supported completion date.

Connect occupancy approval to the rent forecast

In August 2026, WDIV reported move-in delays at Haven on Geddes in Ann Arbor. According to the city, 35 of the property’s 68 units were undergoing renovations and needed certificates of occupancy before residents could move in. The report also said the city subsequently cleared the certificates. The case illustrates why approval status should be tracked at the affected-unit level during renovation.

For a sponsor, the useful connection is between the approval record and each lease’s income start date. Add an approval field to the lease-up schedule, identify the units or suites it covers, and apply the actual delivery and rent commencement provisions. Update the forecast when an approval date changes. A building-wide completion percentage cannot supply those details.

Worked example of a partial opening

Assume a hypothetical 40-unit property has signed leases at $2,000 per unit per month. All tenants are ready to move in, rent starts on lawful delivery, and there are no concessions or collection losses. The original budget assumes all 40 units begin paying at the start of the period.

The authority instead permits occupancy of 24 units. Approval and delivery of the remaining 16 units occur two full months later.

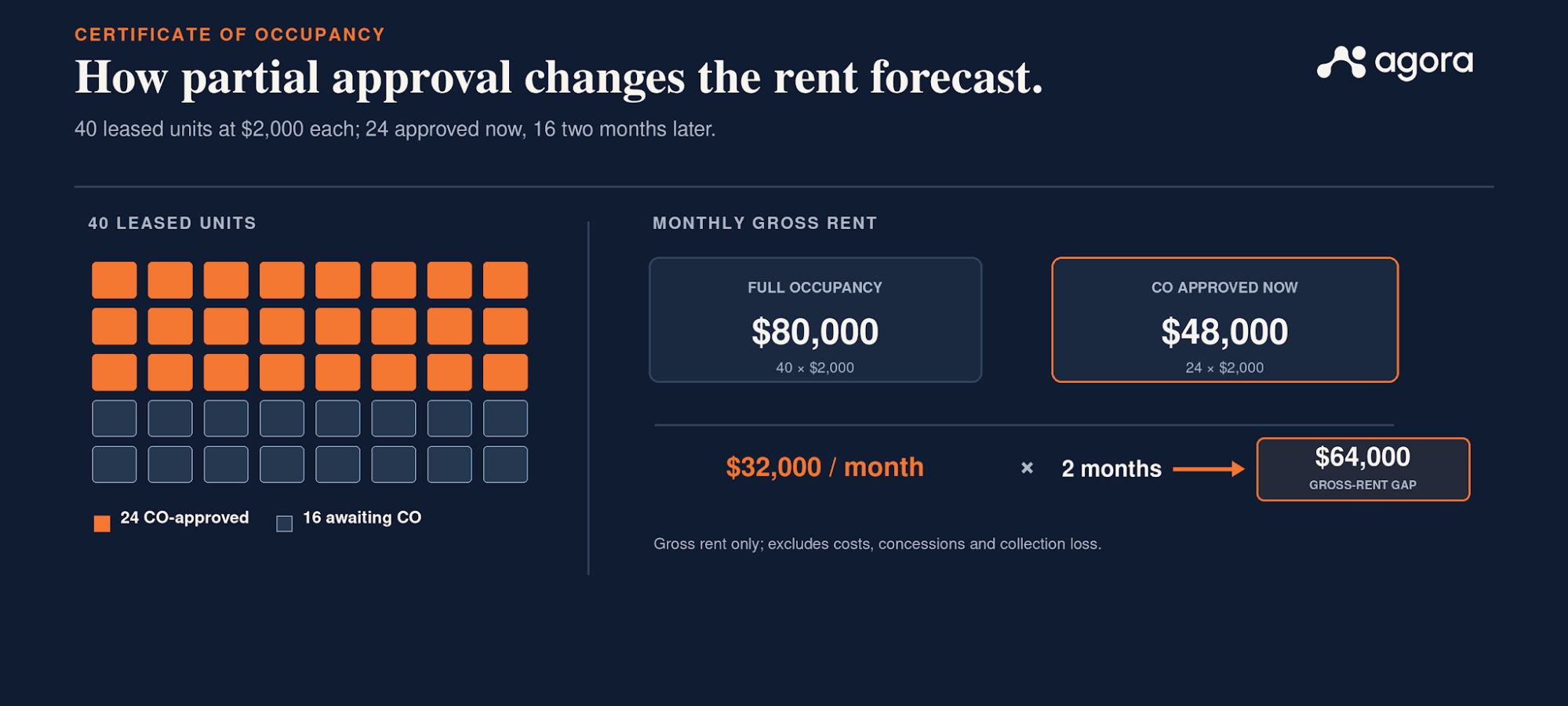

Partial occupancy approval example: 24 of 40 units approved, reducing monthly rent to $48,000 and creating a $64,000 two-month gap.

Certificate of occupancy and rent: 24 of 40 units are approved now; the $32,000 monthly gross-rent gap over two months totals $64,000.

The original monthly gross-rent forecast is $80,000. The approved phase produces $48,000 per month under these assumptions. Across the two affected months, gross rent is $96,000 instead of $160,000, leaving a $64,000 shortfall against the original budget.

That amount measures the gross-rent difference within the two-month period. It excludes operating expenses, financing costs, tenant compensation, and corrective work. Actual lease remedies and later receipts depend on the agreements and circumstances.

In the underwriting model, move the affected rent commencement dates and recalculate cash needs. Include additional costs only where they arise in the delayed scenario, and account for any costs already in the base budget. Then review the effect on available reserves and, where relevant, debt service coverage.

What obtaining a CO costs and how long it takes

The local fee schedule is only one part of the approval budget. Price the required professional work and corrections separately, and include reinspection or temporary-approval renewal costs where applicable. A small application fee can accompany substantial work needed to meet the approval conditions.

There is no dependable national completion timeline. Separate the time to finish work and collect sign-offs from the authority’s processing time after a complete submission. Ask which item currently controls issuance and build the occupancy schedule around that dependency.

Before committing to a handover date, reconcile the expected approval date with the lease and loan milestones. Keep a delay scenario in the project cash forecast so the team can see how long reserves support the revised opening schedule.

Keep the approval record available to the investment team

Retain the current certificate, its covered-area schedule, and the record of outstanding conditions together. Give one person responsibility for keeping temporary approvals current and communicating changes to the asset manager and finance team.

Investor updates should explain the affected space, the expected timing change, and the revised cash forecast. Agora’s document management tools help teams organize supporting records by investment, so the documents behind an update remain accessible.

Conclusion

Confirm that the issued occupancy approval covers the space and use in the business plan. Link that record to each affected lease’s rent commencement terms. When approval is delayed or limited to part of a property, update the income forecast and assign responsibility for the outstanding work.
